Skip to main content

Managed Aquifer Recharge Project

Text: "Little Cottonwood Managed Aquifer Recharge Project" with a blue gradient bar.

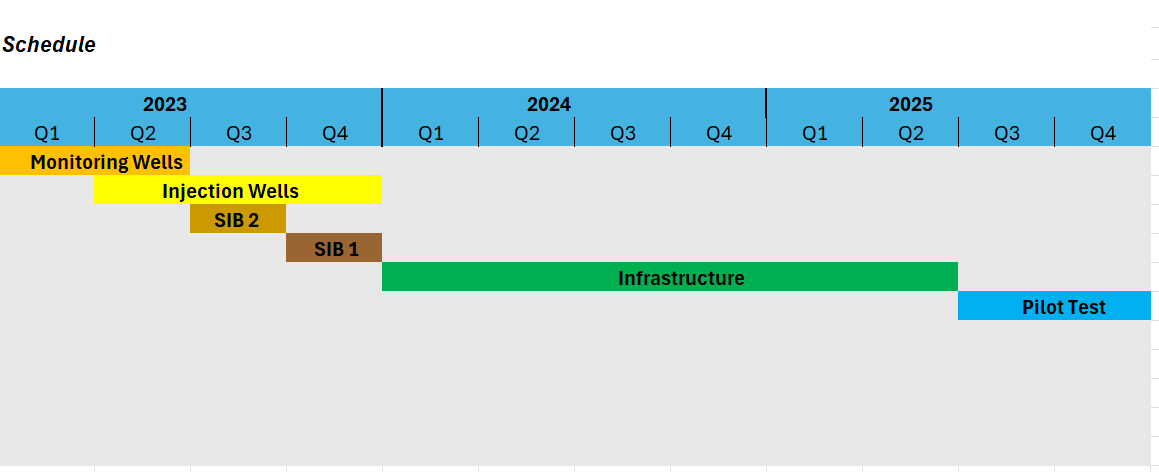

Purpose

Metro Water is constructing managed aquifer recharge (MAR) facilities at the Little Cottonwood Water Treatment Plant (LCWTP). The project will improve the reliability, resiliency, and sustainability of the water supply in Salt Lake County and was partially funded by the American Rescue Plan Act.

An aquifer is an underground formation that holds water. Water from an aquifer can be extracted with a well. Water can also discharge naturally from an aquifer at springs and in wetlands. Ideally, aquifer use balances extraction and recharge, holding as near a net balance as possible. Overuse of an aquifer can lead to increased pumping costs, deeper wells, and dried springs and wetlands. Aquifer effectiveness and resilience are largely dependent on the community’s stewardship.

The MAR program includes several phases of facilities at the LCWTP and other locations. The first phase is a pilot test to better understand the features of the aquifer and its response to recharge. Future phases will be dependent on the pilot test, and are currently anticipated to occur after 2035.

Phase 1 includes

  • Five monitoring wells (MW),
  • An injection well, and
  • 2.3 acres of surface infiltration basins (SIBs) at the LCWTP.

Collectively, these facilities will send up to an estimated 29 acre-feet of water into the aquifer per day when available. Phase 1 was completed in November 2025.

Monitoring Wells

Monitoring wells were completed in June 2023. The five 10-inch diameter monitoring wells vary in depth from 450 to 550 feet deep and are strategically placed around the SIBs and injection well to track the groundwater elevation.

Injection Well

The injection well is 20 inches in diameter and 700 feet deep. Drilling was completed in September 2023.

Surface Infiltration Basins

The surface infiltration basins and site infrastructure were completed in November 2025. The SIBs are large in-ground basins that will hold water at a depth of two feet when in service. The water will infiltrate into the ground and through drain holes within each basin. Site infrastructure refers to piping, vaults, and instrumentation needed to operate the SIBs and the infiltration well.

Pilot Test

Metro Water anticipates running the SIBs annually in the spring to capture surface infiltration basins and site infrastructure were completed in November 2025.

Contact

For questions or concerns related to the project, please contact Augusto Robles at 801-942-9665.

Project Updates

2025

July 2025: Bollards installed around SIBs. UBC access road was completed, Cub and gutter were placed at the construction access north of the Maintenance Building. The PLC cabinet was factory tested on July 16 at 8 am. Start-up possible for the week of August 11. Vault flow meter valves were calibrated and tested. Programming is in place and being tested. Start-up is planned for August 11.

June 2025: PLC panel submittal is in review. COP electricians have pulled the fiber cable, leaving it ready for SKM to finish the installation to the panel. COP installed the last two level transducers in two pre-existing monitoring wells (ID:35195 and 35198). The nitrogen cabinet is on site and will be installed soon. Conduits are installed for SIB-level sensors.

May 2025: COP has installed the well pump, and Electricians are installing the level sensors. SKM is working with staff on programming. We are confirming the scope, including fiver termination and programming.

April 2025: COP is still working on wire connections for PLC. VFD, MDP, and L panels have been received and installed. COP is waiting for the PLC panel to arrive. Salmon Mechanic is installing the ventilating system in the well house.

March 2025: COP is expecting to receive the electrical gear the last week of March, the well pump is anticipated to arrive this week, and Housekeeping pads are being installed in the well house. Electrical contractors are pulling the string through installed conduits. COP installed the permanent doors at the well house. The transformer is installed now. Wire connections are in progress.

February 2025: COP subcontractor still needs to work on the gear concrete pad at the well house; no updates for now.

January 2025: COP is coordinating with the I&E PLC Panel and hardware details. Additionally, there are concerns with the electrical gear concrete pad, VFD and PCL pad, and MDP pad, as well as with Hansen Allen & Luce and Metro Water.

2024

December 2024: COP finished installing the piping in the well house, electricians have all the conduit in, and they also pulled the wire. HVAC  subcontractors will be working on the well house this week.

COP has coordinated with Operations about turning the water on to the 24” pipe in the following days, before Whitaker uses the waterline, and check the vaults and hydrants, and make sure everything is good with the system.

COP electricians also installed well house outlets, lighting, etc.

November 2024: COP electricians are monitoring electrical work in the well house, and the electrical part in the SIB vaults is completed. Contractor has also made trenches for electricians to install conduits to the well house for SCADA and power from the plant to the well house.

October 2024: COP is installing the VFD panel and main distribution Panel.

September 2024: COP installed Well house panels together, including the building roof, temporary doors, the well house window, and the dome.

August 2024: Well house building has arrived at the site. COP started to put the building structure and isolation together.

July 2024: COP is completing the remaining out-fill piping and rip-rap work at the SIBs and the remaining site slab on grade.

June 2024: COP workers installed rebar and poured the Well house concrete slab. The technicians have sealed well ASR Well for safety. Also, allowing the concrete slab to cure.

May 1, 2024: The Contractor has been working on the concrete work around the well house and finishing conduit work left last week. Next week, they will be preparing to finish the concrete at the well house slab and backfilling afterwards.

April 24, 2024: COP electricians are working on getting the conduit installed in the well house. They are grading around the yard hydrants and monitoring wells in preparation for storage material for the Cottonwood Connection project. Next week, they plan to backfill the well pump house.

April 17, 2024: The Contractor poured concrete around the bollards, yard hydrant, and 2 monitoring wells. Next week, they will be working on running the rest of the electrical conduits from the vaults to the well house and finishing work on the under-slab drain piping.

April 3, 2024: The Contractor (COP) is installing the flow meters in both meter vaults, they are also installing the screens on the SIB pipes, and working on concrete pads around the yard hydrant, along with the monitoring wells. They have scheduled to start hydro seeding this weekend, and pouring concrete for the well house foundation. Next week, they will start installing bollards around concrete pads.

March 21, 2024: The contractor is back on site to finish installing the pipe and build the well house. Final grading around the site will be completed in the next few weeks, after which the seed will be broadcast. Electrical work will follow. An updated schedule is in development. Portions of the site, mostly on the northwest, will be available for storing pipe and materials for the Cottonwoods Connection Project. We look forward to sharing more information on that project, including what to expect, in the coming weeks.

January 23, 2024: Well development is wrapping up, and construction is on hold. Updates will be on hold until work resumes, tentatively in March 2024. Remaining work includes the well house, well equipment, and electrical and instrumentation installation.

 January 10, 2024: The contractor continues developing the ASR Well and anticipates completing it in the coming weeks. We are coordinating details for the electrical and mechanical portions of the project. Site work is limited by the snow.

2023

December 20, 2023: The Well Contractor continues developing the ASR Well. They will be taking sand readings while swabbing the rest of the week. They will be cleaning out all the chemicals next week. COP hauled off materials yesterday and today. A sweeper will come on Thursday morning for a final cleaning before Christmas. No work until January 2, 2024.

December 13, 2023: The Well Contractor continues developing the ASR Well. This process will take several months; they are in the chemical treatment phase now. This week, the meter vault to the south SIB meter has been completed, and they will start backfilling and compacting the area. Site grading is almost complete, and some hauling off of debris and cleaning is anticipated next week. The contractor will work Monday through Thursday, December 18 – 21, and then be off until January 2, 2024.

December 13, 2023: The Well Contractor continues developing the ASR Well. This process will take several months; they are in the chemical treatment phase now. This week, the meter vault to the south SIB meter has been completed, and they will start backfilling and compacting the area. Site grading is almost complete, and some hauling off of debris and cleaning is anticipated next week. The contractor will work Monday through Thursday, December 18 – 21, and then be off until January 2, 2024.

We also wish to highlight a separate effort to improve the security of the treatment plant. This includes perimeter fence maintenance and replacement, and servicing barbed wire. Thank you for your understanding.

December 6, 2023: The contractor will continue developing the ASR Well for the next several months. This week, the overflow piping between the SIBs and the pipe connection to the north SIB were installed. Next week, the south SIB meter vault will be installed. Site grading is almost complete. Delays with the ASR Well will extend the project into August 2024, primarily concerning the well house. Staff is preparing an updated schedule. We anticipate seeding will still occur in spring 2024. An updated schedule will be shared on this website within the next week.

November 29, 2023: Widdison Well Services has received approval for the chemical development process, and they are planning to start next week. COP Construction is working on final grading and storm runoff mitigation. Final site grading will continue on November 27 and continue into early December. Native seed will be available during early spring.

November 15, 2023: Well development continues. The development team is still swabbing and awaiting permission to begin chemical development. The chemical development process will help loosen and clean the soil formations around the well and is anticipated to increase water injection rates into the aquifer. COP construction is working this week and until Wednesday, November 22, on rip rap at the SIB inlets. No construction will occur on Thanksgiving or the day after. Final site grading will continue on November 27 and continue into early December. Native seed will be broadcast when appropriate to ensure growth, likely in early spring.

November 8, 2023: Widisson is continuing to work on the swabbing process. They plan to start with the chemical process next week. COP Construction is off this week. ASR concrete deck was poured yesterday.

November 2, 2023: ASR well development team (Widisson) is working on the swabbing process; they are still finding an important amount of sand. Chemical treatment will be the next part of the development process. COP Construction is working on connecting a 24-inch pipe to the SIB meter vaults. Cop construction is still working on berms and access roads.

October 26, 2023: ASR well development team (Widisson) is working on the swabbing part of the well development process. COP  Construction is working on the rebar installation for the ASR Vault and will pour concrete tomorrow afternoon. The ASR meter vault installation at the SIB started today. The drain hole drilling work will be accomplished this week.

October 18, 2023: The ASR well development team (Widisson Well Services) and equipment arrived at the site last Monday. They are setting up the well rig equipment and will start working the next two days. COP Construction is finishing up the drain holes in SIB #2 and will continue working on the SIB drain holes next week. They will connect the 16” HDPE pipe and meter boxes to the SIB next week. All the work will be done during the permitted day hours.

October 11, 2023: Mass excavation is complete. The contractor is now shaping the SIBs and is preparing to drill the drain holes next week. These nine 48-inch diameter drain holes – four in the north basin and five in the south – will be approximately 70 feet deep and filled with gravel. We anticipate they will enhance infiltration into the aquifer. Drilling will occur only during permitted construction hours (i.e., no overnight drilling). Walls for the ASR Vault will be placed next week. Well development is also anticipated to begin on Thursday, October 19th.

October 4, 2023: Off-site hauling of excavated material is mostly complete. Truck traffic will be sporadic moving forward. The contractor is building the vault that will direct treated water to the ASR well for injection. Shaping the SIBs is also in progress. The contractor anticipates the majority of work related to the SIBs to be completed by the end of November 2023. Site piping, electrical, and related work will continue into next year. The SIBs are expected to be functional by the end of February 2024, with the well several months later.

September 28, 2023: The ASR well is constructed. Development will begin in the next few weeks. Sound walls were removed. Excavation on the south infiltration basin is expected to finish in the next two to three weeks.

September 20, 2023: The ASR Well contractor is in the process of moving off the worksite. Sound walls are scheduled to be taken down next Tuesday. Excavation work continues at the south infiltration basin, with 10 trucks on rotation per day.

September 13, 2023: The ASR well is drilled, and the casing and gravel pack are installed. Swabbing (the first part of development) is anticipated to run through the end of next week. Excavation work continues on the south infiltration basin.

September 6, 2023: The ASR well is 646 feet (of 715 feet) deep. The contractor is optimistic that drilling will be completed on Friday, at which point the well casing will be installed and the gravel pack installed. Development will begin early next week. Initial development will run 24 hours a day for several days. The sound walls will then come down, and development will resume with smaller, quieter equipment. Excavation on the north basin was completed today, and the same on the south basin began.

August 31, 2023: The ASR well pilot hole is complete, and reaming reached 457 feet deep this morning. Excavation for the north SIB is ongoing. We are grateful to the community for its patience and understanding during these noise and traffic disruptions.

August 31, 2023: The ASR well pilot hole is complete, and reaming reached 457 feet deep this morning. Excavation for the north SIB is ongoing. We are grateful to the community for its patience and understanding during these noise and traffic disruptions.

August 16, 2023: The ASR well pilot hole reached 487 feet deep with an 18-inch bit. The drill was tripped out, equipped with a 20-inch bit, and reached 509 feet deep this morning. After the 20-inch bit reaches 715 feet, the hole will be widened with a 28-inch diameter reamer. Excavation for the SIBs began on Tuesday and will continue into September. Trucks will enter and exit the treatment plant from Danish Road to Wasatch Boulevard, Monday through Friday, approximately 7:00 am to 4:30 pm.

August 16, 2023: The ASR well pilot hole reached 487 feet deep with an 18-inch bit. The drill was tripped out, equipped with a 20-inch bit, and reached 509 feet deep this morning. After the 20-inch bit reaches 715 feet, the hole will be widened with a 28-inch diameter reamer. Excavation for the SIBs began on Tuesday and will continue into September. Trucks will enter and exit the treatment plant from Danish Road to Wasatch Boulevard, Monday through Friday, approximately 7:00 am to 4:30 pm.

August 2, 2023: The conductor casing for the new ASR well was completed on July 31. Drilling will resume on August 3. The SIB and infrastructure contractor are installing site piping this week. They may begin excavation on the northernmost SIB as early as next week.

July 26, 2023: Unfortunately, the broken reamer could not be retrieved, and the ASR well was lost. The well was abandoned following state requirements. The contractor began drilling today for a new conductor casing. They expect to have the conductor casing in and grouted by Friday. Drilling to 700 feet will begin Monday and is anticipated to last for four to six weeks. Work on the surface infiltration basins also began this week. The contractor anticipates installing site piping next week and will begin excavation on SIB 2 (the northernmost basin) the week of August 7. We are working with the contractor to ensure dust stays under control.

July 26, 2023: Unfortunately, the broken reamer could not be retrieved, and the ASR well was lost. The well was abandoned following state requirements. The contractor began drilling today for a new conductor casing. They expect to have the conductor casing in and grouted by Friday. Drilling to 700 feet will begin Monday and is anticipated to last for four to six weeks. Work on the surface infiltration basins also began this week. The contractor anticipates installing site piping next week and will begin excavation on SIB 2 (the northernmost basin) the week of August 7. We are working with the contractor to ensure dust stays under control.

July 12, 2023: The well contractor is trying to fish out the broken portion of the reamer. Once fishing is successful, the contractor has about two more weeks of work to complete the well. At that point, the sound wall and drill rig will be removed from the site. Development of the well will follow during daytime hours for about three months. The basin contractor began work this week.

July 6, 2023: At 652 feet deep, the reamer shank sheared. The contractor is now attempting to fish out the broken piece before finishing the well reaming. Work on Phase 2, which includes the infiltration basins, piping, and wellhouse, will begin the week of June 10.

June 30, 2023: Monitoring wells are complete! The ASR well is reamed to 569 feet. The SIB contractor will mobilize the week of July 3 and begin work the week of July 10. A postcard update will be shared with neighboring property owners the week of July 3.

June 21, 2023: The final monitoring well, MW3b, is expected to be completed this week. Materials for the ASR began to arrive this week. The contractor started reaming the well on June 17 and is currently about 250 feet deep. Work will be 24/7 for about the next four weeks as the hole is reamed, the well casing and screen installed, the gravel pack installed, and the well capped. Well development will follow in mid-to-late July. Work on the SIBs is anticipated to begin in early July.

June 15, 2023: MW3b will be equipped and developed next week. Reaming on the ASR well may begin as early as this weekend. Work on the surface infiltration basins is anticipated to begin after July 4. Written notice will be sent to neighboring property owners.

June 7, 2023: Hydro Resources, the well driller, continues to make good drilling progress with monitoring well 3b (MW3b). A casing, which will arrive next week, will enable the last 50 feet of drilling to take place. COP Construction, the contractor for the Surface Infiltration Basins, began soil sampling this week.

June 1, 2023: MW5 is complete. Drilling on MW3b began June 1. MW3b is the replacement for the lost MW3 and will be drilled just west of MW3. The next phase of the project will see the construction of the surface infiltration basins and the equipping of the ASR well. The contractor will mobilize and prepare the site in June and anticipates work in earnest after July 4.

May 24, 2023: MW5 drilling is complete. The well will now be equipped and developed. The contractor will then move to MW3. The ASR Well reached 710 feet on May 20, and the well design is in process. We anticipate the reaming process to begin in about two weeks. Award of the surface infiltration basins is anticipated on June 12, with work beginning in July 2023.

May 18, 2023: MW5 is nearly complete. The ASR Well is 603 feet deep as of 7 am on May 17. We anticipate the award of the surface infiltration basins at the June 12 board meeting, with work beginning in July 2023.

May 11, 2023:MW4 is complete, and MW5 is drilled to 180 feet. MW5 is going slower due to the soil formation, which has a lot of quartz at this location. Following MW5, the contractor will drill MW3 again. Unfortunately, the well was lost. After several days of downtime due to a stuck tool, drilling on the ASR well resumed on May 10. As of 7 am on May 11, the drill reached 401 feet. We are reviewing three bids for the next part of the project in anticipation of an award on June 12. The project was featured on ABC4! Watch the story here.

May 3, 2023:The contractor is finalizing MW4 and preparing to move to MW5. The lower piezometer on MW3 was lost and will require the drill to be drilled again. Drilling on the ASR Well began late on April 30 and is now about 250 (of 700) feet deep. We recognize and apologize for the disruption to the community from sound and lighting during this process. The team continues to balance those impacts with providing a good quality work product. Please contact Ammon Allen at (801) 942-9687 or allen@mwdsls.org with any questions.

April 26, 2023: The contractor expects to complete drilling on MW4 this weekend. The well will be developed next week. The ASR well contractor is mobilizing and expects to begin drilling Saturday afternoon. Bids for SIB construction are due May 10.

April 12, 2023: There is some delay in finishing up MW3 as 160’ of PVC pipe was dropped into the hole. The contractor will finish removing that pipe, then complete the piezometers before moving on to MW4, tentatively at the beginning of next week. The ASR well contractor will begin mobilizing to the site over the next week and anticipates starting to drill next week. Notices of the updated dates on the noise permit were mailed to property owners within 800’ of the ASR well on April 6. A copy of that permit is available in the Project Directories list to the left.

April 5, 2023: Drilling on MW3 was completed on April 1. The well is being developed this week. The contractor expects to begin drilling MW4 next week. The ASR well contractor anticipates beginning the week of April 17.

March 30, 2023: The contractor expects to finish drilling for MW3 this weekend and complete MW3 next week. He will then move to MW4.

March 22, 2023: The contractor set the conductor casing and is drilling MW3.

March 15, 2023: The contractor is staging and will begin MW3 next week.

March 8, 2023: Drilling for MW1 is complete. The well will now be developed. Drilling on MW3 is expected to begin next week. ASR Well drilling was delayed due to an equipment malfunction and is now anticipated in early April.

March 1, 2023: The 40’ conductor casing on MW1 was installed on February 28. The contractor is now drilling to 450 feet. Sound walls are up in preparation for the ASR well drilling, which is anticipated to begin mid-March. A picture of the sound wall configuration is shown below.

March 1, 2023: The 40’ conductor casing on MW1 was installed on February 28. The contractor is now drilling to 450 feet. Sound walls are up in preparation for the ASR well drilling, which is anticipated to begin mid-March. A picture of the sound wall configuration is shown below.

2022

Dec 19, 2022: Drilling for MW2 is anticipated to begin Wednesday, Dec 21. The contractor will work through Friday, Dec 23. Drilling is expected to continue on Tuesday, Dec 27 to Friday, Dec 30. Drilling will then begin again on Tuesday, Jan 3.
